AI/BI dashboard visualization types

This page outlines the types of visualizations available to use in AI/BI dashboards and shows you how to create an example of each visualization type. For instructions on building a dashboard, see Create a dashboard.

Important

This page covers visualizations for AI/BI dashboards. For visualizations in Azure Databricks notebooks and the SQL editor, see Notebook and SQL editor visualization types.

For information about visualization rendering limits, see Dashboard limits.

Area visualization

Area visualizations combine the line and bar visualizations to show how one or more groups' numeric values change over the progression of a second variable, typically that of time. They are often used to show sales funnel changes through time.

To adjust the layout:

  • Click the Kebab menu icon. kebab menu in the Y Axis section of the visualization editing panel.

  • In the Layout section, choose Stack or 100% Stack.

Area visualization example

Configuration values: For the provided area visualization example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Area

  • Title: Total price and order year by order priority and clerk

  • X-axis:

    • Field: o_orderdate

    • Transform: Yearly

    • Scale Type: Continuous

    • Display name: Order year

  • Y-axis:

    • Field: o_totalprice

    • Display name: Total price

    • Scale Type: Continuous

    • Transform: Sum

  • Color:

    • Field: o_orderpriority

    • Legend title: Order priority

  • Filter

    • Field: TPCH orders.o_clerk

SQL query: For this area visualization, the following SQL query was used to generate the dataset named TPCH orders.

SELECT * FROM samples.tpch.orders;

Bar chart

Bar charts represent the change in metrics over time or across categories and show proportionality, similar to a pie visualization.

Bar visualization example

To adjust the layout:

  • Click the Kebab menu icon. kebab menu in the Y Axis section of the visualization editing panel.

  • In the Layout section, choose Stack or 100% Stack, or Group.

Configuration values: For the provided bar chart example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Bar

  • Title: Total price and order month by order priority and clerk

  • X-axis:

    • Field: o_orderdate

    • Transform: Monthly

    • Scale Type: Continuous

    • Display name: Order month

  • Y-axis:

    • Field: o_totalprice

    • Scale Type: Continuous

    • Transform: Sum

    • Display name: Total price

  • Color:

    • Field: o_orderpriority

    • Legend title: Order priority

  • Filter

    • Field: TPCH orders.o_clerk

SQL query: The following SQL query generated the dataset TPCH orders for this bar visualization.

SELECT * FROM samples.tpch.orders;

Box chart

The box chart visualization shows the distribution summary of numerical data, optionally grouped by category. Using a box chart visualization, you can quickly compare the value ranges across categories and visualize the locality, spread, and skewness groups of the values through their quartiles. In each box, the darker line shows the interquartile range.

Box chart example

For the provided box chart example, the following values were set:

  • X column (dataset column): l-returnflag

  • Y columns (dataset column): l_extendedprice

  • X display name: Return flag1

  • Y display name: Extended price

SQL query: For this box chart visualization, the following SQL query was used to generate the dataset.

SELECT * FROM samples.tpch.lineitem;

Bubble chart

Bubble charts are scatter charts where the size of each point marker reflects a relevant metric. To make a bubble chart, select Scatter as your visualization type. In the Size setting, select the metric you want represented by the size of the markers.

Bubble chart visualization example

Configuration values: For the provided bubble chart example, the following values were set:

  • Dataset: NYC taxi trips

  • Visualization: Scatter

  • Title: Trip distance, fares, and trip duration

  • X-axis:

    • Field: trip_distance

    • Scale type: Continuous

    • Transform: None

  • Y-axis:

    • Field: fare_amount

    • Scale type: Continuous

    • Transform: None

  • Color by:

    • Field: pickup_zip
  • Size:

    • Field: minutes_in_taxi

    • Transform: None

SQL query: For this bubble chart visualization, the following SQL query was used to generate the dataset.

SELECT
  *,
  TIMESTAMPDIFF(MINUTE, tpep_pickup_datetime, tpep_dropoff_datetime) AS minutes_in_taxi
FROM samples.nyctaxi.trips
LIMIT 500;

Choropleth map

In choropleth visualizations, geographic localities, such as countries or states, are colored according to the aggregate values of each key column. The query must return geographic locations by name. Users can create maps that display administrative boundaries at the country, state or province, and county or district level.

Choropleth map example

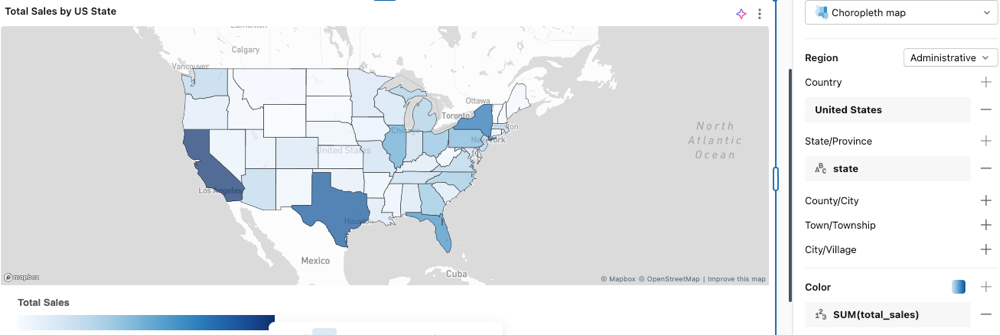

For a configuration example and choropleth map options, see Choropleth options.

Cohort chart

Cohort charts visualize user retention and behavior patterns over time by grouping users based on a shared characteristic (such as sign-up date) and tracking their activity across subsequent time periods. This visualization helps you understand how different cohorts of users engage with your product or service over time.

Cohort chart example

To create a cohort chart, use a pivot visualization with retention data. The following example tracks customer retention by calculating when customers first placed an order (their cohort date) and measuring how many customers from each cohort remain active in subsequent years. The color scale indicates retention rates, with darker colors showing higher retention.

Configuration values: For this cohort chart example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Pivot

  • Title: Customer retention by cohort year

  • Rows:

    • Field: Cohort

    • Transform: Yearly

  • Columns:

    • Field: Active Period
  • Cell:

    • Field: Retention

    • Style: Color Scale

SQL query: For this cohort chart visualization, the following SQL query was used to generate the dataset Orders cohort analysis.

-- get the list of customers and when they were active
WITH history AS (
 SELECT o_orderdate, o_custkey -- replace with the right columns representing date and id
 FROM samples.tpch.orders -- replace with desired table
 GROUP BY ALL
),
-- find the date of the first order for each customer
cohort AS (
 SELECT o_custkey, MIN(o_orderdate) AS first_date
 FROM history
 GROUP BY 1
),
-- combine the customer activity table with the date of first activity, and choose a granularity (e.g. YEAR)
joined AS (
 SELECT
   DATE_TRUNC("YEAR", first_date) AS cohort,
   CAST(DATE_DIFF(YEAR, cohort, o_orderdate) AS STRING) AS active,
   o_custkey
 FROM history LEFT JOIN cohort USING(o_custkey)
),
-- calculate the number of distinct customers by cohort and date active
grouped AS (
 SELECT cohort, active, COUNT(DISTINCT o_custkey) AS customers
 FROM joined
 GROUP BY 1, 2
),
-- calculate the number of initial customers for each cohort
initial_customers AS (
 SELECT cohort, customers AS t0_customers
 FROM grouped
 WHERE active = 0
)
-- calculate the retention by cohort and date active
SELECT
  cohort AS Cohort,
  active AS Active,
  CASE WHEN active = 1 THEN CONCAT(active, " year")
    ELSE CONCAT(active, " years") END AS `Active Period`,
  customers AS Customers,
  t0_customers AS `Initial Customers`,
  TRY_DIVIDE(customers, t0_customers) AS Retention
FROM grouped LEFT JOIN initial_customers USING (cohort)
WHERE active > 0;

Combo chart

Combo charts combine bar and line visuals on a shared X-axis to present the changes over time with proportionality. You build a combo chart from layers. Each layer is a bar or line visual with its own fields, so you can combine a bar layer with a line layer, two bar layers, or two line layers. You can also color a bar layer by category and pair it with a line layer.

Existing combo charts open in the layer-based editor automatically. The bar fields and the line fields of an existing chart each become one layer.

Combo chart example

Configuration values: For this combo chart visualization, the following values were set:

  • Dataset: samples.nyctaxi.trips

  • Visualization: Combo

  • X-axis: tpep_pickup_datetime

    • Transform: Weekly

    • Scale Type: Continuous

  • Y axis layers:

    • Bar layer: trip_distance

      • Transform: Average
    • Line layer: trip_distance

      • Transform: Median

SQL query: For this combo chart visualization, the following SQL query was used to generate the dataset.

SELECT * FROM samples.nyctaxi.trips;

Build a combo chart with layers

To build a combo chart from layers:

  1. With your visualization widget selected, set Visualization to Combo in the visualization editing panel.

  2. In the X axis section, choose a field. All layers share this field.

  3. In the Y axis layers section, click Add layer and choose Bar or Line.

  4. Select the layer and add one or more fields to its Value section. Each value field appears as a separate series with its own color.

  5. (Optional) To color a layer by a category, click the layer in the Y axis layers section to open its settings and add a field to the Color section. A layer with a color field supports only one value field. To add more values to the layer, remove the color field first.

  6. Repeat steps 3 through 5 to add more layers.

When you click a layer in the Y axis layers section, its settings also include these options:

  • Visual: Switch the layer between Bar and Line.

  • Line shape: For a line layer, choose Linear, Smooth, or Step. See Line shape.

  • Labels: Show data labels for the layer. A bar layer can also show the totals of stacked bars.

The layout of a bar layer is set in a separate menu. To change it, click the Kebab menu icon. kebab menu labeled Layer settings next to the layer's Value section. In the Layout section, choose Stack, 100% Stack, or Group. If a line layer shares the same Y-axis, the 100% Stack option isn't available.

Dual-axis combo chart

You can use combo charts to show two different Y-axes. With your combo chart widget selected, click the Kebab menu icon. kebab menu in the Y axis layers section of the visualization editing panel. Turn on the Enable dual axis option.

The Y axis layers section then groups the layers under Left Y axis and Right Y axis. To move a layer to the other axis, drag it to the other group. To configure an axis, click the Kebab menu icon. kebab menu next to its group name.

Dual-axis combo chart example

Configuration values: For this combo chart, the Enable dual axis option is on. The other configurations are set as follows:

  • Dataset: samples.nyctaxi.trips

  • Visualization: Combo

  • X-axis: tpep_pickup_datetime

    • Transform: Weekly

    • Scale Type: Continuous

  • Y axis layers:

    • Left Y axis, bar layer: trip_distance

      • Transform: Average
    • Right Y axis, line layer: fare_amount

      • Transform: Average

SQL query: The following SQL query was used to generate the dataset:

SELECT * FROM samples.nyctaxi.trips;

Counter visualization

Counters display a single value prominently, with an option to compare them against an offset value. To use counters, specify which data to display on the counter visualization for the Value and Comparison columns. Optionally, choose a date column and aggregation to show a sparkline in the chart.

Counter example

You can set conditional formatting and customize the text style in the Value configuration details.

Conditional formatting options for the displayed counter chart.

Hide date labels and the sparkline

By default, the counter shows date labels beside the current and comparison values, along with a background sparkline. You can hide each element independently. These controls change only the display, so existing dashboards continue to show both elements.

  • To hide the background sparkline, turn off the Show sparkline switch in the Sparkline section of the counter editor. Hiding the sparkline removes only the background chart. It does not change the counter value, the comparison, or the underlying query.

  • To hide the dates shown beside the current and comparison values, select Hide date labels in the date field's settings popover. Hiding the date labels does not remove the date field, which remains active for sorting and period comparisons.

Format template

To add custom prefix or suffix text around a counter value, enable Format template in the Value configuration details. Use {{ }} syntax to reference values in the template:

  • {{ @ }} — the raw counter value

  • {{ @formatted }} — the formatted counter value, with any number formatting applied

  • {{ FieldName }} — any other dataset field, such as {{ Region }} or {{ SUM(Profit) }}

Configuration values: For this counter visualization example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Counter

  • Title: Orders: Total price by date (compared to the previous day)

  • Value:

    • Date: DAILY(o_orderdate)

    • Value: total price

  • Comparison:

    • Field: o_orderdate

    • Days ago offset: -1

SQL query: For this counter visualization, the following SQL query was used to generate the dataset:

SELECT
  SUM(o_totalprice) AS `total price`,
  o_orderdate
FROM
  samples.tpch.orders
GROUP BY o_orderdate
ORDER BY o_orderdate DESC;

Funnel chart

The funnel chart helps analyze the change in a metric at different stages. To use the funnel, specify a step and a value column.

For example, the following funnel chart shows how users progress through stages of a signup flow. Each stage represents a step in the process, with its size reflecting the number of users who reached that step.

Funnel example

Configuration values: For this funnel chart, the following values were set:

  • Dataset: User Engagement Funnel Stages

  • Visualization: Funnel

  • X axis: stage

  • Y axis: count

    • Aggregation type: SUM
  • Color column:

    • Dataset column: count

SQL query: The following SQL query generated the dataset for this funnel chart visualization.

SELECT *
FROM VALUES
  ('Visited Website', 10000),
  ('Signed Up', 4000),
  ('Activated Account', 2500),
  ('Added First Item', 1500),
  ('Completed Purchase', 800)
AS funnel(stage, count);

Gantt chart

Gantt charts display data as horizontal bars on a continuous axis, encoding the start, end, and duration of each item at a glance. Use them to visualize project schedules, manufacturing workflows, and other events that span a range of time.

Each bar spans from a start value to an end value on the x-axis. The start and end fields must be the same type: date, datetime, or numeric.

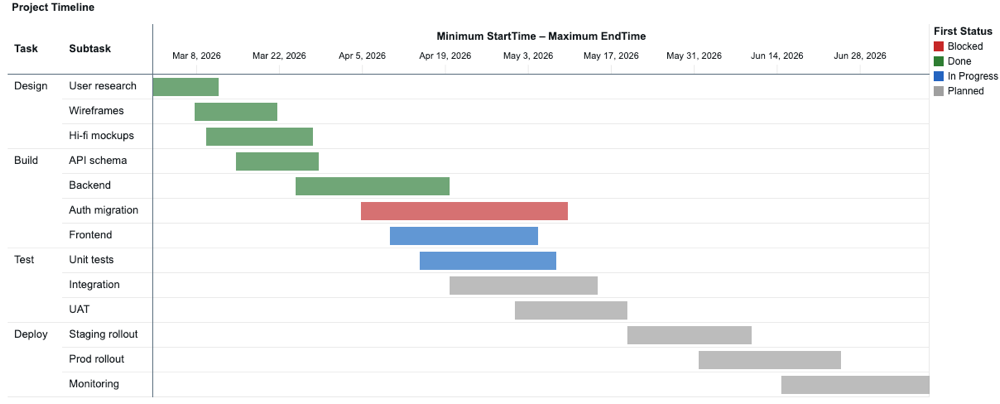

Gantt chart example

Configuration values: The following Gantt chart example uses these values:

  • Dataset: Project Tasks

  • Visualization: Gantt

  • Rows:

    • Task

    • Subtask

  • Range:

    • Start: MIN(StartTime)

    • End: MAX(EndTime)

  • Color:

    • Field: FIRST(Status)

SQL query: The following SQL query generates the dataset named Project Tasks for this Gantt chart visualization.

SELECT * FROM VALUES
  ('Build', 'API schema', DATE'2026-03-15', DATE'2026-03-29', 'Done'),
  ('Build', 'Auth migration', DATE'2026-04-05', DATE'2026-05-10', 'Blocked'),
  ('Build', 'Backend', DATE'2026-03-25', DATE'2026-04-20', 'Done'),
  ('Build', 'Frontend', DATE'2026-04-10', DATE'2026-05-05', 'In Progress'),
  ('Deploy', 'Monitoring', DATE'2026-06-15', DATE'2026-07-10', 'Planned'),
  ('Deploy', 'Prod rollout', DATE'2026-06-01', DATE'2026-06-25', 'Planned'),
  ('Deploy', 'Staging rollout', DATE'2026-05-20', DATE'2026-06-10', 'Planned'),
  ('Design', 'Hi-fi mockups', DATE'2026-03-10', DATE'2026-03-28', 'Done'),
  ('Design', 'User research', DATE'2026-03-01', DATE'2026-03-12', 'Done'),
  ('Design', 'Wireframes', DATE'2026-03-08', DATE'2026-03-22', 'Done'),
  ('Test', 'Integration', DATE'2026-04-20', DATE'2026-05-15', 'Planned'),
  ('Test', 'UAT', DATE'2026-05-01', DATE'2026-05-20', 'Planned'),
  ('Test', 'Unit tests', DATE'2026-04-15', DATE'2026-05-08', 'In Progress')
AS tasks(Task, Subtask, StartTime, EndTime, Status);

Heatmap chart

Heatmap charts blend features of bar charts, stacked charts, and bubble charts, allowing you to visualize numerical data using colors.

For example, the following heatmap visualizes the count of orders based on their priority and shipping method. The x-axis represents different order priorities, while the y-axis represents various shipping methods. The color intensity indicates the sum of order counts, with a legend showing the order count scale.

Note

Heatmaps can display up to 64K rows or 10MB.

Heatmap example

Configuration values: For this heatmap chart visualization, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Heatmap

  • X axis: priority

  • Y axis: ship_mode

  • Color column:

    • Dataset column: order_count

    • Aggregation type: SUM

  • X-axis name (override default value): Order Priority

  • Y-axis name(override default value): Shipping method

  • Color ramp: Green Blue

SQL query: For this heatmap chart visualization, the following SQL query was used to generate the dataset.

SELECT
    o.o_orderpriority AS priority,
    l.l_shipmode AS ship_mode,
    COUNT(*) AS order_count,
    o.o_orderdate
FROM
    samples.tpch.orders AS o
JOIN
    samples.tpch.lineitem AS l
ON
    o.o_orderkey = l.l_orderkey
GROUP BY
    o.o_orderpriority,
    l.l_shipmode,
    o.o_orderdate
ORDER BY
    priority,
    ship_mode;

Histogram chart

A histogram plots the frequency that a given value occurs in a dataset. A histogram helps you to understand whether a dataset has values that are clustered around a small number of ranges or are more spread out. A histogram is displayed as a bar chart in which you control the number of distinct bars (also called bins).

Histogram chart example

Configuration values: For this histogram chart visualization, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Histogram

  • X column (dataset column): o_totalprice

  • Number of bins: 20

  • X-axis name (override default value): Total price

Configuration options: For histogram chart configuration options, see histogram chart configuration options.

SQL query: For this histogram chart visualization, the following SQL query was used to generate the dataset.

SELECT * FROM samples.tpch.orders;

Line visualization

Line visualizations present the change in one or more metrics over time.

Line visualization example

Configuration values: For this line visualization example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Line

  • Title: Average price and order year by order priority and clerk

  • X-axis:

    • Field: o_orderdate

    • Scale Type: Continuous

    • Transform: Yearly

    • Display name: Order year

  • Y-axis:

    • Field: o_totalprice

    • Scale Type: Continuous

    • Transform: Average

    • Display name: Average price

  • Color:

    • Field: o_orderpriority

    • Legend title: Order priority

SQL query: For this line chart visualization, the following SQL query was used to generate the dataset named Orders data.

SELECT * FROM samples.tpch.orders;

Line shape

For line and area visualizations, and for line layers in combo charts, the Line shape control sets how the chart connects data points:

  • Linear: Connects points with straight segments. This is the default.

  • Smooth: Connects points with a curved line.

  • Step: Connects points with horizontal and vertical segments that form a stepped line.

The Line shape control isn't available for a line that uses the Size encoding.

Path map

Path maps display lines on a map. Each line is drawn from a geometry column in the result set or by connecting a sequence of points in order. Use them to visualize routes, transit lines, rivers, or point-by-point trajectories such as GPS tracks.

Path map example

For a configuration example and path map options, see Path map options.

Pie visualization

Pie visualizations show proportionality between metrics. They are not meant for conveying time series data.

Pie visualization example

Configuration values: For this pie visualization example, the following values were set:

  • Dataset: samples.tpch.orders

  • Visualization: Pie visualization

  • Title: Total price by order priority and clerk

  • Angle:

    • Field: o_totalprice

    • Transform: Sum

    • Display name: Total price

  • Color:

    • Field: o_orderpriority

    • Legend title: Order priority

  • Filter

    • Field: TPCH orders.o_clerk

SQL query: For this pie visualization, the following SQL query was used to generate the dataset named TPCH orders.

SELECT * FROM samples.tpch.orders;

Pivot visualization

A pivot visualization aggregates records from a query result into a tabular display. It's similar to PIVOT or GROUP BY statements in SQL. You configure the pivot visualization with drag-and-drop fields.

For detailed information about pivot table configuration options, including sticky headers, conditional formatting, and adding links, see Pivot table configuration.

Pivot example

Configuration values: For this pivot visualization example, the following values were set:

  • Dataset: samples.tpch.lineitem

  • Visualization: Pivot

  • Title: Line item quantity by return flag and ship mode by supplier

  • Rows:

    • Field: l_returnflag

    • Display total: Checked

  • Columns:

    • Field: l_shipmode

    • Display total: Checked

  • Values

    • Field: l_quantity

    • Transform: Sum

SQL query: For this pivot visualization, the following SQL query was used to generate the dataset named TPCH lineitem.

SELECT * FROM samples.tpch.lineitem;

Point map

Point maps display quantitative data as symbols placed at specific map locations. Markers are positioned using latitude and longitude coordinates, which must be included as part of the result set for this chart type.

Point map example

For a configuration example and point map options, see Point map options.

Sankey diagram

A sankey diagram visualizes the flow from one set of values to another.

Sankey example

Configuration values: For this sankey diagram, the following values were set:

  • Dataset: samples.nyctaxi.trips

  • Visualization: Sankey

  • Stages

    • stage1

    • stage2

    • stage3

  • Value

    • SUM(value)

SQL query: For this Sankey visualization, the following SQL query was used to generate the dataset.

SELECT
  CASE
    WHEN pickup_zip BETWEEN 10000 AND 10299 THEN 'Manhattan'
    WHEN pickup_zip BETWEEN 11200 AND 11299 THEN 'Brooklyn'
    WHEN pickup_zip BETWEEN 11300 AND 11499 THEN 'Queens'
    ELSE 'Other'
  END AS stage1,

  CASE
    WHEN dropoff_zip BETWEEN 10000 AND 10299 THEN 'Manhattan'
    WHEN dropoff_zip BETWEEN 11200 AND 11299 THEN 'Brooklyn'
    WHEN dropoff_zip BETWEEN 11300 AND 11499 THEN 'Queens'
    ELSE 'Other'
  END AS stage2,

  CASE
    WHEN fare_amount < 8 THEN 'Low'
    WHEN fare_amount <= 15 THEN 'Medium'
    ELSE 'High'
  END AS stage3,

  SUM(fare_amount) AS value
FROM samples.nyctaxi.trips
GROUP BY 1, 2, 3
ORDER BY value DESC
LIMIT 50;

Scatter visualization

Scatter visualizations are commonly used to show the relationship between two numerical variables. You can encode the third dimension with color to show how the numerical variables differ across groups.

Scatter example

Configuration values: For this scatter visualization example, the following values were set:

  • Dataset: samples.tpch.lineitem

  • Visualization: Scatter

  • Title: Total price and quantity by ship mode and supplier

  • X-axis:

    • Field: l_quantity

    • Display name: Quantity

    • Scale type: Continuous

    • Transform: None

  • Y-axis:

    • Field: l_extendedprice

    • Scale type: Continuous

    • Transform: None

    • Display name: Price

  • Color:

    • Field: l_shipmode

    • Legend title: Ship mode

  • Filter

    • Field: TPCH lineitem.l_supplierkey

SQL query: For this scatter visualization, the following SQL query was used to generate the dataset named TPCH lineitem.

SELECT * FROM samples.tpch.lineitem

Table visualization

The table visualization shows data in a standard table but allows you to manually reorder, hide, and format the data.

Note

Tables can display up to 64K rows or 10MB.

Table example

Configuration values: For this table visualization example, the following values were set:

  • Dataset: samples.tpch.lineitem

  • Visualization: Table

  • Title: Line item summary by supplier

  • Columns:

    • Display row number: Enabled

    • Field: l_orderkey

    • Field: l_extendedprice

      • Format: Custom

      • Type: $ (Currency)

    • Field: l_discount

      • Format: Custom

      • Type: % (Percent)

    • Field: l_tax

      • Format: Custom

      • Type: % (Percent)

    • Field: l_shipdate

    • Field: l_shipmode

  • Filter

    • Field: TPCH lineitem.l_supplierkey

Configuration options: For table visualization configuration options, see Table and pivot table visualizations.

SQL query: For this table visualization, the following SQL query was used to generate the dataset named TPCH lineitem.

SELECT * FROM samples.tpch.lineitem

Waterfall chart

Waterfall charts display the cumulative effect of sequential positive and negative values, showing how an initial value is affected by a series of intermediate positive and negative values. They are commonly used to visualize financial data, such as profit and loss statements, or to show how different factors contribute to a total change.

Waterfall chart example

Configuration values: For this waterfall chart example, the following values were set:

  • Dataset: Generated by query

  • Visualization: Waterfall

  • X-axis: MONTHLY(date_col)

  • Y-axis: SUM(amount)

SQL query: For this table visualization, the following SQL query was used to generate the dataset.

with base as (
  SELECT
    *
  FROM
    VALUES
      (2535, '2025-01-01'),
      (-853, '2025-02-01'),
      (3229, '2025-03-01'),
      (1820, '2025-04-01'),
      (3195, '2025-05-01'),
      (-1800, '2025-06-01'),
      (-562, '2025-07-01'),
      (-332, '2025-08-01'),
      (1750, '2025-09-01'),
      (-330, '2025-10-01'),
      (3300, '2025-11-01'),
      (4400, '2025-12-01') AS t (amount, date_str)
)
SELECT
  amount,
  cast(date_str as date) as date_col
from
  base

Customize the waterfall total bar

A waterfall chart can end with a total bar that shows the cumulative result of all the steps. The total bar is off by default. To show it, turn on the Show total switch in the Total section of the waterfall editor.

When the total bar is shown, you can customize it:

  • Color: Use the color swatch in the Total section to set the color of the total bar. The color applies only to the total bar, not to the step bars.

  • Display name: Click the Kebab menu icon. kebab menu in the Total section, and then enter a Display name to rename the total bar on the x-axis, for example Net income. If you leave the field empty, the bar is labeled Total.

  • Label: In the same menu, use the Label control to choose whether the total bar shows its value label:

    • Auto: Follows the label setting for the rest of the chart. This is the default.

    • Show: Always shows the value label on the total bar, even when labels are off for the rest of the chart.

    • Hide: Always hides the value label on the total bar, even when labels are on for the rest of the chart.
